The project 'iron triangle' is actually four dimensional (time, cost, scope and quality) but misses the most vital element - value



Understanding the 'Iron Triangle'

The project fraternity lauds the 'iron triangle' - time, cost and specification (scope). These are their primary parameters. However, the Project triangle is actually four dimensional - consisting of scope, cost, time and quality.

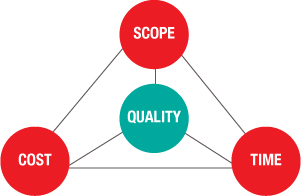

Project Triangle

Quality

Quality is a critical component because, as Gerry Weinberg observes, "If quality is an option all else is possible!" (You may just need to think about that one.)

So, everyone on a project must always be focused on the project's quality - are this solution and outcomes fit for purpose and to the agreed quality standards?

Occasionally, the governance team should personally assess the quality of some of the project's physical outputs and review the effectiveness of the quality management steps - testing, user evaluation, etc. If the outputs are not the required quality then the project is in trouble.

So quality is the given. What about the other three?

Scope

Scope controls the value. Increases in scope must be assessed in terms of their impact on the project's value. "No increase in value, no scope increase" should be the rule.

Scope reductions must also be assessed in terms of their impact on value. Any scope reductions that reduce the project's value attack the very raison d'etre of the project - the delivery of the business outcomes, benefits and value.

On one recent project, the Steering Committee had agreed to drop a component that was seen as peripheral to the main focus of the project. But then our value equation for the project  showed this component delivered 62% of the business value. It was restored.

So, scope is a critical governance lever to control and protect the project's value. No proposed scope changes should escape a rigorous value-impact challenge.

Cost

Cost is a dimension that has high visibility outside of the project. You're allocated a certain amount of funds and if you go 'over budget' you have to go, cap in hand, to a management body and ask for (and justify) more funds. Very visible and very embarrassing. Few executives want to do this.

In the 1990s budget overruns were the norm. "We did well," said one Sponsor in 1999, "we came in only 70% over budget."

Since 2000 most organizations have clamped down on budget overruns. But in doing so, they have often ensured that their projects' long term value is foregone to meet short-term budget constraints.

The problem is often that the 'budget' is set too early when there are too many unknowns. So the budget is by definition wrong.

(Where projects are over-estimated they rarely come in under budget. Instead they tend to finesse the project to consume the funds available.)

However, if you're faced with a decision to, say, lose $2m in ongoing benefits in order to 'save' $1m in additional one-time expenditure, you're not doing your organization any favors in cutting scope to 'make budget'.

Always remember Tom Peter's comment, "The worst thing a manager can have on his tombstone is 'made budget'."

To realize the value you may have to go over budget; it's a value trade-off. (Sounds of CFOs fainting in horror.)

Time

Time drives more than costs, it also reduces value through delaying the realization of the benefits and, therefore, their lifetime value.

So time has a double impact - increasing costs while decreasing value. You need to know your project's cash 'burn rate' to understand the cost impact of any time increase.

You also need to know your value realization rate to understand the value impact of any project delivery delay (often this is greater in the long run than the cost impact because it is ongoing).

Value

Each of the "infernal project pyramid's" dimensions has an impact on the project value. So, if you have to compromise, the decision=making rule of thumb is to

  1. go over budget
  2. before you go over time
  3. which you should do before you change scope
  4. or, lastly, compromise quality.

Ideally, of course, you'll deliver all of the value on time, budget and to specification.

But no one said it was easy.



Explore project succes and how to achieve it more
